Government Housing Programme Techos de Esperanza in no Tangible Advance

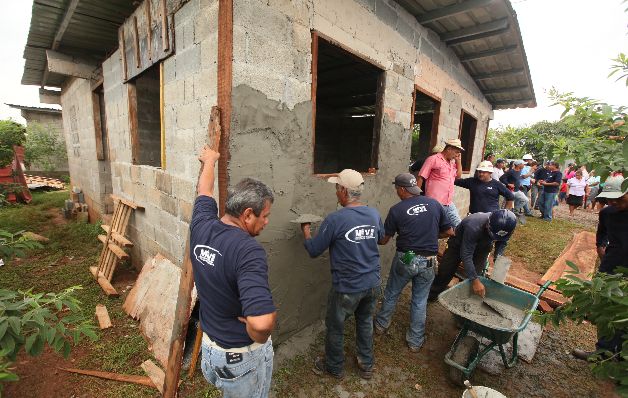

The 22 fields currently in operations as part of the government’s housing programme Techos de Esperanza would not suffice to achieve the proposed delivery goals over the next two years: to this day, progress stands at a mere 5%.
Government Housing Programme Techos de Esperanza in no Tangible Advance
The 22 fields currently in operations as part of the government’s housing programme Techos de Esperanza would not suffice to achieve the proposed delivery goals over the next two years: to this
day, progress stands at a mere 5%.
One of the reasons behind such delays is that, of the total of 15,000 housing units under contruction, only 5,800 have actually have been awarded necessary construction permits by the Housing Ministry (Miviot).
Additionally, 15 projects are suffering from delays is the poor execution of the required administrative processes, whose extra costs add up to an estimated $150 million.
Housing Minister Mario Etchelecu has clarified that all current construction fields are simultaneous working on 600 dwellings, representing 13,200 housing units. The construction of dwellings takes approximately one to one-and-a-half year, depending on the quantity of housing units. The vast majority is scheduled for delivery in 2017, according to initial plans. However, in the past five years, such a number of dwellings has, in reality, never achieved completion. In fact, there are projects that, in spite of time extensions to their original deadlines, are yet to be completed. Such is the case of the Urbanización Génesis project, which today stands at 70% completion rate. This is in spite of having 107 housing units ready for delivery: what is missing in this case is the formal transfer of property rights of the actual land.
Other projects have become embroiled in legal issues, as is the case for the Ave Fénix site, currently at a mere 22% completion, in spite of construction having started on 20 December 2013. This specific project has been suspended and is currently awaiting a Supreme Court decision: according to a report by the Housing Ministry: “the project’s construction contract is in the process of being terminated, and a new tender launched”.
An Abundance of Irregularities
The Techos de Esperanzas Project was kicked off on 18 August 2014 in the Altos de Las Torres neighbourhood, part of the San Miguelito district. No information on its current completion rate is known. Similarly, residents of Arraiján, part of the West Panama district, claim that Housing Ministry officials were seen on a proposed site over a year ago: “they took measurements of the proposed land site, but have not been seen since”.
In the Chiriqui province, residents of Los Abanicos 3 have denounced the lack of tangible results so far, while complaining about a large number of irregularities. Faced with this situation, the local community has taken to occupying the site and paralyzing the works. Indeed, since President Juan Carlos Varela first announced this project, inconsistencies have only been adding up. Darlenys Muñoz, a local resident, has revealed that multiple workers have been sacked over the past three months, and that some benefits – such as holiday pay – have been left unpaid. Adding to the concerns of local dwellers, houses show no signs of completion.
